The 90-Day Ramp Problem: Why Most Staff Augmentation Engagements Fail to Deliver in Q1

Let's start with the part nobody wants to say out loud
Staff augmentation has a ramp problem and honestly it's not a new one. The people who feel it most aren't the vendors — it's the Engineering Directors who signed off on the engagement, took the business case upstairs, and then spent a quarter watching the numbers go nowhere.
The story tends to follow the same arc. Engagement kicks off, engineers seem solid, and over the first couple of weeks everyone's finding their feet. By Week 4 something is moving but not at the pace anyone expected. Week 6 you're doing arithmetic you don't want to be doing including how much actually shipped, how many hours your internal team spent fielding questions from people brought in to add capacity, not consume it. By the close of Q1 there are three months of invoices and maybe four or five weeks of output you'd genuinely call meaningful.
Then comes the part where you need to explain it to someone above you.
We've been in enough of those conversations, on both sides of the table, to have a clear picture of what's going on. It's not a vendor quality problem. It's not a talent problem either, though that's usually where the blame ends up. The problem is structural and it starts earlier than most people think.
Structured onboarding improves productivity by over 60% and cuts time-to-contribution by around 40% and those figures apply to permanent hires with job security and a genuine reason to push through the friction of early weeks. Augmented engineers are working from a different starting position. They show up without organizational history, often don't know a single person on the team, and there's a quiet expectation of usefulness that kicks in almost immediately. A permanent hire taking three months to find their footing is frustrating. An augmented engineer taking three months probably costs you the quarter.
It’s not the engineers, it’s the setup
When a ramp goes badly the post-mortem almost always circles back to the engineers. Were they senior enough, did they have the stack experience their CV suggested, should vetting have flagged something. It's not an unreasonable place to look but it’s usually the wrong one.
By the time an augmented engineer opens their first ticket, the shape of the engagement is already largely determined, and skill level has very little to do with it.
What mattered was the two weeks before they arrived. Whether anyone actually owns the integration. Whether the team has ever worked out what "productive in 30 days" means. When that structure isn't there, it doesn't really matter what the engineer is capable of.
The 8 reasons it keeps happening
Across more than fifty engagements the pattern is frustratingly similar. It's never one critical failure — it's eight smaller ones, none of them fatal on their own, but together capable of consuming an entire quarter before anyone's worked out what went wrong. None of them are mysterious, and none require significant investment to fix. They just require someone to actually own fixing them, which is itself one of the problems.
| Reason | Problem | Fix |
|---|---|---|
| Toolchain access delay | GitHub, Jira, VPN, cloud environments — each owned by a different team, each a separate request, none treated as urgent. The engagement starts on paper Day 1. In practice, it starts around Day 8 to 12. Two sprints gone before meaningful code gets written. | Treat access as a pre-start deliverable. Provision and verify everything 5 business days before the engineer arrives. One person owns a checklist, confirms it works end to end. Thirty minutes of effort — still the most reliably skipped step. |

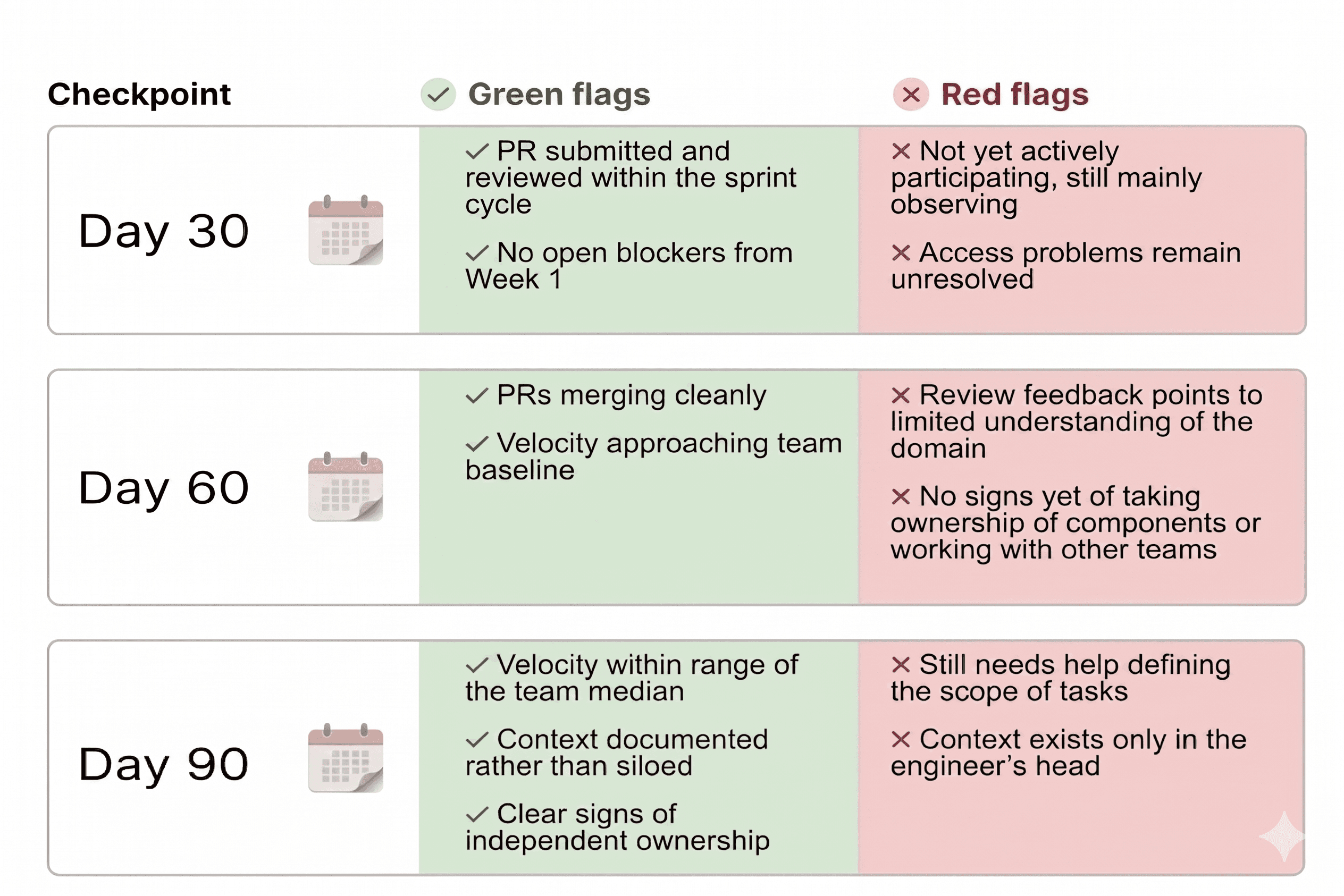

| No named onboarding owner | Ask who's accountable if the ramp goes badly and you'll get a pause, then something noncommittal. Blockers don't get flagged and something a ten-minute conversation could fix in Week 1 is still there in Week 4, slightly bigger |
